Construction activity for March 7 - 21

Publish Date
Body



What to expect during the next two weeks* (March 7 - 21):

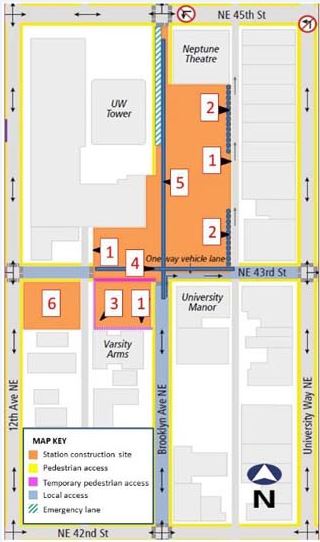

The locations for the work listed below are shown on the project map.

  1. Continue building the wooden wall around the construction site.
  2. Continue installing concrete foundations to support the future station.
  3. Continue building the pedestrian pathway between NE 43rd Street and Brooklyn Avenue NE. Once complete, the pathway will be open Monday through Friday between 7 a.m. and 6 p.m.
  4. Continue utility work on NE 43rd Street from west of Brooklyn Avenue NE to the alley within the project construction zone.
  5. Begin utility work on Brooklyn Avenue NE from just south of NE 43rd Street to NE 45th Street.
  6. Begin to prepare the site for a temporary construction office. Trees will be trimmed and the site will be leveled for temporary trailers.

Equipment: trucks, excavators, jackhammers, drill rigs, crane, generators, street sweepers

Alt text required

On the horizon (After March 21)*:

  • Continue building the wooden wall around the construction site.
  • Continue utility work on NE 43rd Street from west of Brooklyn Avenue NE to the alley.
  • Begin utility work along NE 42nd Street between Brooklyn Avenue NE and University Way NE. This work was initially scheduled for March and has been re-scheduled for April 2014.
  • Close the intersection at NE 43rd Street and Brooklyn Avenue NE to vehicular traffic to construct a temporary bridge. Pedestrian access will be maintained during this work. The intersection will close this spring and is expected to reopen to vehicular traffic in fall 2014.
